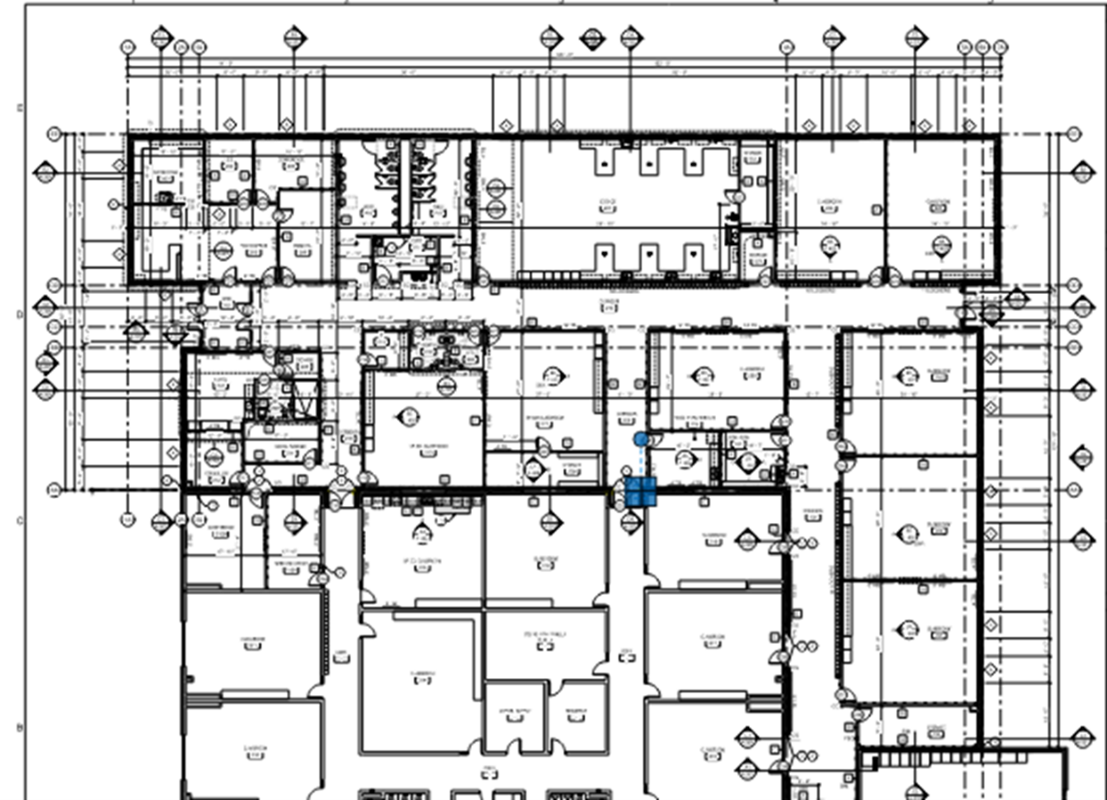

Hermosa K-8 School Project

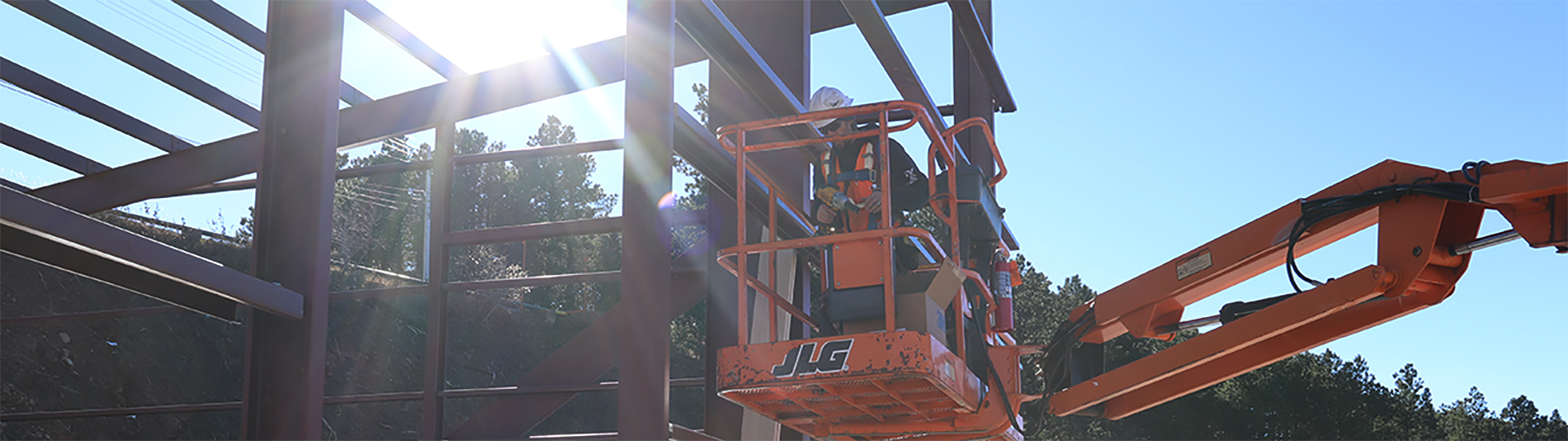

We are making great progress on the K-8 Hermosa School project for the Custer School District #16-1. Phase 1 is completely framed and about 85% roughed in for electrical and mechanical. Approximately 80% of the sheetrock is installed and being finished taped and textured to get ready for painting in the near future. Interior finishes will start coming together in the next couple of weeks. Exterior site work inclusive of sidewalks, curb and gutter and the playground area will begin about mid-May.
Full Details

*

Multi-Aircraft Hangar Building

Full Details

*

Sanford Underground Research Facility

We are getting ready to wrap up our Sanford Underground Research Facility project in Lead, South Dakota. Drywall is complete throughout the building as well as paint in the office areas. Moving forward we have various finishing jobs to get done. Trim will need to be added throughout the building and acoustic tiles will be added to reduce sound. We are excited to be announcing the finished product very shortly.
